Information
-
Document No.
-
Conducted on
-
Prepared by
-
Location
-
Personnel involved
SECTION 1 - Risk Assessment
SECTION 1 - Risk Assessment
-
Document the hazards and analyse the risks associated with the entry and work activities to be undertaken with respect to the confined space
-
Reason For Entry
-
Description of Work Activity
-
Nature of Work to be Undertaken
-
Confined Space to be Entered
-
Description of Confined Space
-
Confined Space Catagory
-
MINIMUM STANDARD ENTRY CONTROLS
- A pre-entry atmospheric test -
MINIMUM STANDARD ENTRY CONTROLS
- Pre-entry venting to ensure a safe atmosphere
- A pre-entry atmospheric test
- A stand-by person to be in constant communication with entry personnel -
MINIMUM STANDARD ENTRY CONTROLS
- Pre-entry and continuous venting to ensure a safe atmosphere
- A pre-entry atmospheric test and continuous atmospheric monitoring
- A stand-by person to be in constant communication with entry personnel
- Provision of retrieval and rescue equipment at the immediate confined space location -
Please consult your Test & Poly Supervisor
Risk Assessment Guide
-
Step 1 - Consider Concequences

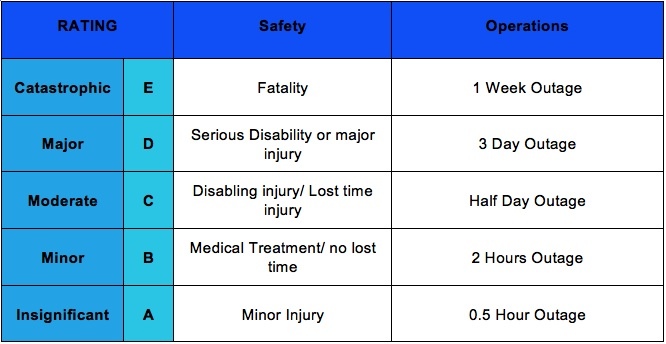

What are the consequences of this hazard occurring? Consider what is the most probable consequence (below) with respect to this work hazard -
-
Step 2 - Consider Likelihood

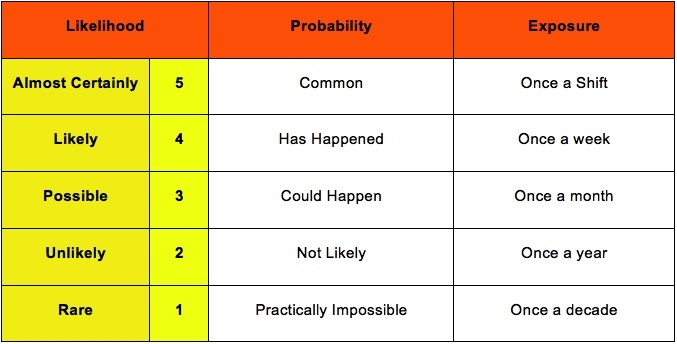

What is the likelihood (below) of the hazard consequence in Step 1 occurring? -
-

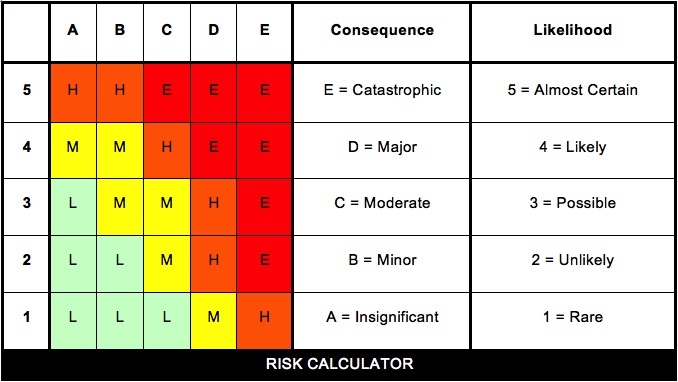

Step 3 - Calculate Risk
1. Take Step 1 Rating and select the correct column
2. Take Step 2 Rating and select the correct row
3. Use the risk score where the two ratings cross on the below matrix
E = Extreme
H = High
M = Moderate
L = Low -
Hazard Identification
-
Slips, Trips and Falls
-
Controls to Manage the Hazard
- Tools Lanyard
- Compliant Ladder
- PPE -
Other Controls Required?
-
Clearly list any other Controls required
-
Responsible Party to Implement Controls
-
Who is responsible to implement the nominated controls
-
Risk Rating with all nominated Controls in place
-
Traffic and/or pedestrians
-
Controls to Manage the Hazard
- Barricades & Signage
- Traffic Control & Devices -
Other Controls Required?
-
Clearly list any other Controls required
-
Responsible Party to Implement Controls
-
Who is responsible to implement the nominated controls
-
Risk Rating with all nominated Controls in place
-
Chemical / Fume Inhalation
-
Controls to Manage the Hazard
- Induction, Venting and/or Extraction
- Gas Detecting & Monitoring -
Other Controls Required?
-
Clearly list any other Controls required
-
Responsible Party to Implement Controls
-
Who is responsible to implement the nominated controls
-
Risk Rating with all nominated Controls in place
-
Drowning
-
Controls to Manage the Hazard
- Pump out all Water
- Check Plug Integrity Prior to Entering -
Other Controls Required?
-
Clearly list any other Controls required
-
Responsible Party to Implement Controls
-
Who is responsible to implement the nominated controls
-
Risk Rating with all nominated Controls in place
Risk Assessment Personnel
-
Name, Employer and Signature
-
Select date
-
Name, Employer and Signature
-
Select date
-
Name, Employer and Signature
-
Select date
SECTION 2 - Entry Permit
-
Isolation Controls
This Confined Space needs to be isolated from -
Water / Gas / Steam / Chemicals
-
Mechanical / Electrical Drives
-
Hydraulic / Electric / Gas / Power
-
Sludge / Deposits / Waste
-
Auto Fire Extinguishing Systems
-
Locks &/or Tags will be Affixed to Isolation Points
-
Other
-
Purging, Ventilation & Atmospheric Monitoring Controls
This Confined Space requires the following -
Depressurising
-
Opening / Venting
-
Continuous Purging / Extraction
-
Atmospheric Testing Required for
-
Oxygen (O2)
-
Carbon Monoxide (CO)
-
Hydrogen Sulphide (H2S)
-
Carbon Dioxide (CO2)
-
LEL
-
Ammonia (NH3)
-
Volatile Organic Compounds (VOC)
-
Other
-
Type of Testing / Monitoring Required
-
Initial Only - Prior to entry and each subsequent day
-
Continuous for Atmospheric Contaminants
-
Continuous for Flammable Contaminants
-
Communication & Stand By Controls
Minimum Requirements will include -
One Stand By Person
-
Two or More Stand By Persons
-
Rescue Team
-
Communication Via Voice and Direct Sight
-
Communication Via Radio
-
Communication Via Hand Signals and Other Means
-
Rescue / Retrieval Considerations
Minimum Provisions are to include -
Stand By Person to individually handle
-
Safety Harness / Rescue Kit in vicinity with competent user(s)
-
Specific access to platforms/scaffolding erected
-
Specific Fire fighting provisions
-
First aid kit in vicinity
-
Other
-
Personal Protective Equipment (PPE) Requirements
Minimum items required -
Supplied breathing apparatus
-
Air purifying respirator
-
Particulate mask
-
Safety harness and lanyard / lifeline
-
Head protection
-
Face shield / goggles / safety glasses
-
Ear muffs / plugs
-
Gloves
-
Warning notices / barricading
-
Specific lighting provisions
-
Specific hot work controls
-
Other
Permit Request
-
This acknowledgement signifies a formal request to commence confined space entry / works. As the person requesting this permit, I hereby certify that; 1. I am competent to coordinate this confined space entry / work in accordance with the previous Risk Assessment & Entry Permit details; 2. I shall undertake to implement all planned and necessary controls to ensure safe entry / work; 3. I shall monitor confined space hazards and control methods throughout the entry / work;
Permit Authorisation
-
This authorisation signifies that the planning component of the Risk Assessment & Entry Permit has been completed and that the confined space entry / work is authorised to commence in accordance with the Permit Request.
SECTION 3 - Implementation
-
Atmospheric Test Results
-
Test Time & Date
-
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
Other
-
Gas Detector Number
-
Entry Permitted?
-
Personnel taking results
-
Another test
-
Atmospheric Test Results
-
Test Time & Date
-
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
Other
-
Gas Detector Number
-
Entry Permitted?
-
Personnel taking results
-
Another test
-
Atmospheric Test Results
-
Test Time & Date
-
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
Other
-
Gas Detector Number
-
Entry Permitted?
-
Personnel taking results
-
Another test
-
Atmospheric Test Results
-
Test Time & Date
-
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
Other
-
Gas Detector Number
-
Entry Permitted?
-
Personnel taking results
-
Another test
-
Atmospheric Test Results
-
Test Time & Date
-
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
Other
-
Gas Detector Number
-
Entry Permitted?
-
Personnel taking results
-
Another test
-
Atmospheric Test Results
-
Test Time & Date
-
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
Other
-
Gas Detector Number
-
Entry Permitted?
-
Personnel taking results
-
Another test
-
Atmospheric Test Results
-
Test Time & Date
-
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
Other
-
Gas Detector Number
-
Entry Permitted?
-
Personnel taking results
-
Another test
-
Atmospheric Test Results
-
Test Time & Date
-
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
NOT SAFE TO ENTER
Re-Test and confirm safe limits with supervisor -
Other
-
Gas Detector Number
-
Entry Permitted?
-
Personnel taking results
-
Another test
Entry Authorisation
-
The procedures, control measures and precautions appropriate for the safe entry / work in this confined space have been implemented and the persons required to work in the confined space have been David of and understand the requirements of the Risk Assessment & Entry Permit
-
Time & Date Signed
-
CONSTRAINTS This Entry Authorisation is valid until the following occurs or the time and date shown
-
Select date
Personnel Entry
-
I the undersigned, hereby acknowledge that I fully understand the procedure, control measures and precautions to be observed with the entry / work and exit involved with this confined space. I will comply with these requirements at all times and report any unforeseen hazard that presents a risk to safety
-
Name and signature of operator
Withdrawal of Entry Authorisation
-
All persons and equipment has been accounted for and the equipment and confined space has been restored correctly and safely
-
Supervisor name and signature
