Title Page
-
Pit Number
-
Site
-
Personnel present
-
Location
-
Conducted on
-
Prepared by
Health and Safety
-
Compliant to Health and Safety as per UFF and contractors policy, OSH guidelines.
-
Have you signed onto site.
-
Take a photo of the Sign on sheet (ensure the correct focus)
-
Have you sighted the contractors JSA.
Pit Excavation / Placement
-
Pit has been positioned as per design rules.
-
Placement is correct - 3m away from poles, 5m from an intersection, safe from traffic where local conditions allow.
-
Excavation is correct, 150 - 200mm deeper than the pit, 300 - 400mm around the sides of the pit.
-
The bottom of the excavation conforms with the general ground slope.
-
Base foundation - a minimum of 100mm layer of rammed crusher dust free from foreign material.
-
Additional notes and comments.
Duct Entry
-

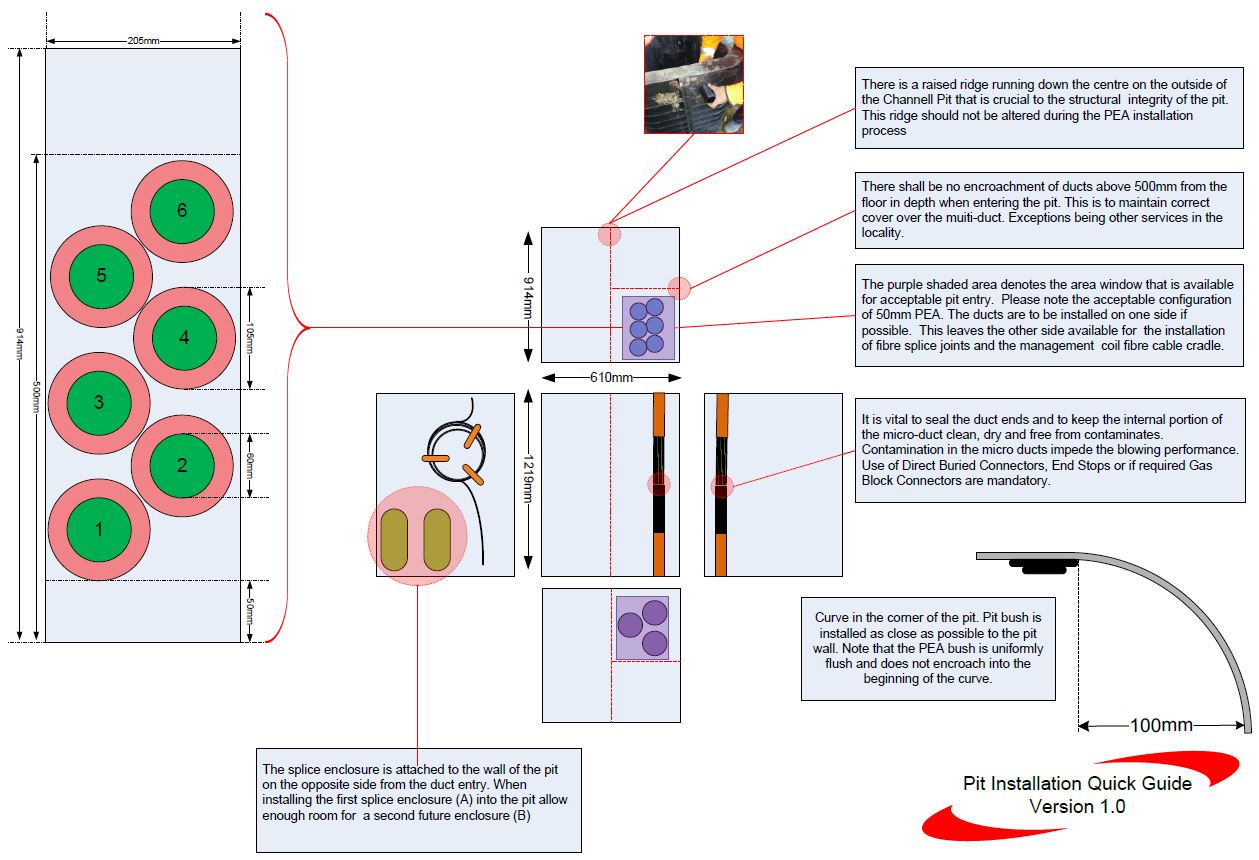

Pit layout
-
Multi-ducts bundles trench or drill shot gradually aligns with the entry points into the pit where local conditions allow.
-
Is the alignment correct.
-
Duct enters the narrowest end of the pit.
-
Pit internals
-
Photograph overview of the manhole internal to show entire pit layout.
-
Ducts installed on one side only to leave room for the joint enclosure and fibre loop management.
-
Ducts position into pit, a minimum of 50mm from the floor and 100mm from the pit wall is desirable.
-
Duct separation from other ducts, minimum of 25mm (to allow installation of the pit bush).
-
Duct hole size is correct - 20mm duct = 30mm hole, 50mm duct = 66mm hole, 100mm duct = 123mm hole.
-
100mm Starter Duct installed for multiple entries.
-
Starter duct fitted with pit bush.
-
Gaps around pit bush sealed with approved sealant where necessary.
-
All ducts sealed with ROCPAC. (7 way 14/10mm duct entry exempt in accordance with TU 028)
-
Additional Notes / Comments.
Reinstatement
-
Correct backfill and compaction used. Layer compaction of 200mm of earth.<br>Tap the side of the pit to listen for hollow sounds. If the surround is soil, probe the surround with the pit lifters to check ground density.
-
record issues observed. Take a photo of the ground penetration using the pit lifter.
-
Reinstatement around the pit correct and complete.
-
Photograph the overview of manhole surround from different angles.
-
Pit left clean and tidy inside.
-
Lid placed correctly locked and bung installed.
-
Is there any further information that should be recorded that has not been mentioned in the audit?
Labeling
-
Labelling Examples
Manhole Label - HW0004
Splice Enclosure -HW0004A, HW0004B
Feeder duct- HMW_402[0004A], HMW_402[0004Y],HMW_402[0004Z],HMW_402[0004X]
Feeder cable sheath into a splice enclosure - HMW102[0004A], HMW102[0004Y],HMW102[0004Z],HMW102[0004X]
Feeder cable sheath for a coil - HMW402[0004]
ADSS cable sheath - HW54763_A1[0004A] -
Is the manhole label present and in the correct format.
-
Photograph label if not captured above.
-
If transition tubes are used are the labels present and correct.
-
Close-up photograph of all labels (ensure focus is correct)
-
Multi-ducts present and correct.
-
Close-up photograph of all labels (ensure focus is correct)
-
If splice enclosure is present, is it labelled and in the correct format.
-
Close-up photograph of all labels (ensure focus is correct)
-
Fibre sheath labels present and in the correct format.
-
Close-up photograph of all labels (ensure focus is correct) .
-
Is there any further information that should be recorded that has not been mentioned in the audit?
-
Signature of auditor
