Title Page
-
Job Name: Wheel wash Stapylton Landfill Facility
-
Job Number: 4041
-
Site Location
-
Conducted on
-
Prepared by
Conduit Installation
-
CB ENERGY - STAPYLTON LANDFILL CONDUIT INSTALLATION
-
Has the the existing roadway been saw cut?
-
Length of trench (mtrs)
-
Has the trench been excavated to the required depth?<br>(850mm - 900mm)<br>Photo of trench depth.
-
Has bedding sand been installed?<br>(75mm minimum)<br>Photo of bedding sand.
-
Has the conduit/s been installed with correct cover?<br>(600mm minimum cover required)<br>Photo of conduit depth.
-
Have the conduits been covered with sand and electrical marker tape installed? <br>Photo of warning tape installed.
-
Has the the trench been backfilled with lean mix in layers?<br>(approx 150mm - 200mm)
-
Photo evidence - Lean mix layer 1
-
Photo evidence - Lean mix layer 2
-
Photo evidence - Lean mix layer 3 Is key-in to existing required
-
Has the the conduit installation and backfilled been completed as per the design, and the work area been left safe & clean?
Asphalt Reinstatement
-

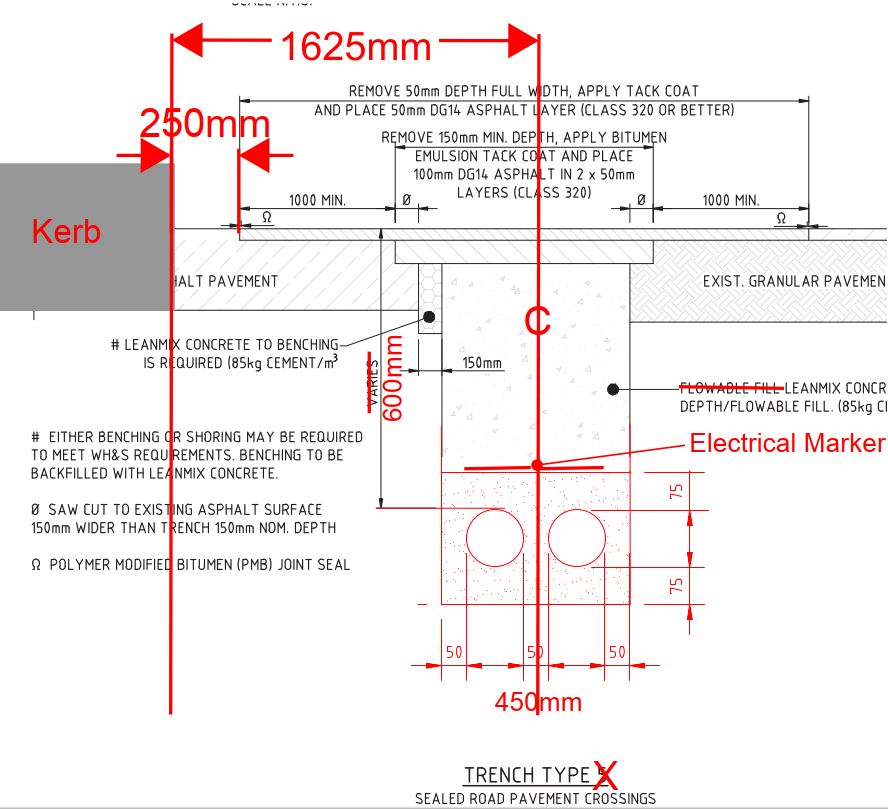

Has the existing pavement been milled to the correct width and depth?<br>(Refer to asphalt reinstatment Mark up)
-
Photos of Asphalt installation
-
Emulsion tack coat - Photo required
-
Asphalt key-in layer #1 - 50mm DG14
-
Asphalt key-in layer #2 - 50mm DG14
-
Asphalt top layer wearing course - 50mm DG14
-
Has the asphalt been smooth drum rolled to the required compaction levels?
-
Has Polymer Modified Bitumen (PMB) Joint Seal tape been installed along aspalt joints?
